Bimini Basin Mooring Field Project

See More City Projects >>

Scope of work:
This project includes all of the design and permitting required to construct a 15-buoy mooring field in the Bimini Basin at Four Freedoms Park.  Additional infrastructure includes the removal and replacement of the existing park seawall, a dinghy dock, a modular building (e.g., public and private restrooms, a shower, a laundry room, and a storage room), a pump out station, a Captain’s walk, and connecting sidewalks.

Timeline:
The Mooring Field Management Plan has been substantially completed for permitting. The FDEP permit was received on 8/22/25, and is awaiting ACOE permit, which was submitted 12/23/24. Permit review was delayed due to the government shutdown in October/November 2025. The ACOE approval of this permit is expected March 2027.

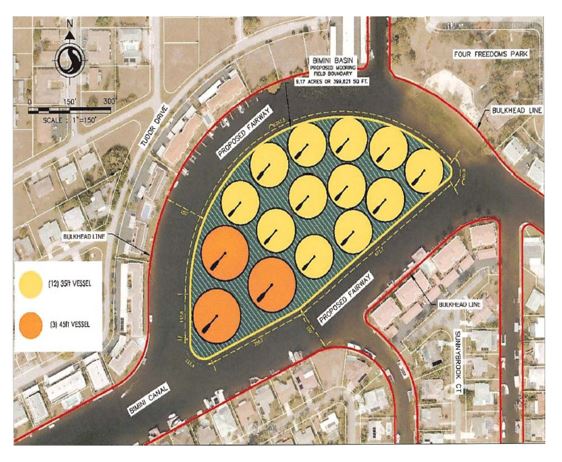

proposed mooring field map, showing 15 mooring locations
Proposed layout of the mooring field
